3-13-2025 Monthly Project Update
The Board of Directors for Lake McQueeney Water Control and Improvement District No. 1 (LMWCID 1, or “the District”) would like to provide residents an update on the work performed so far at the dam for the Lake McQueeney Spillgate Replacement and Dam Armoring Project.
Schedule Status:
Substantial completion date is late-September 2025
Current Work Status:

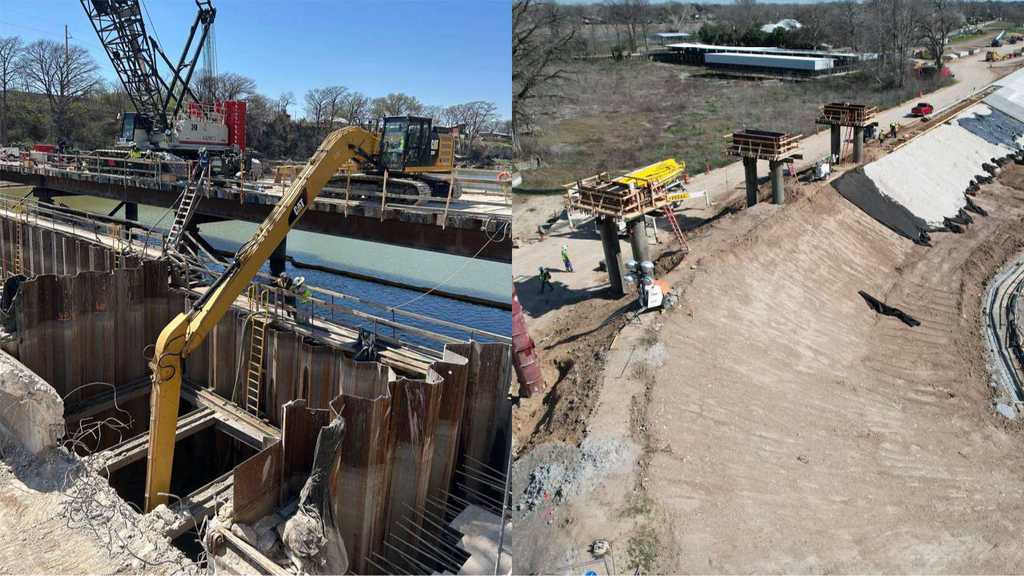

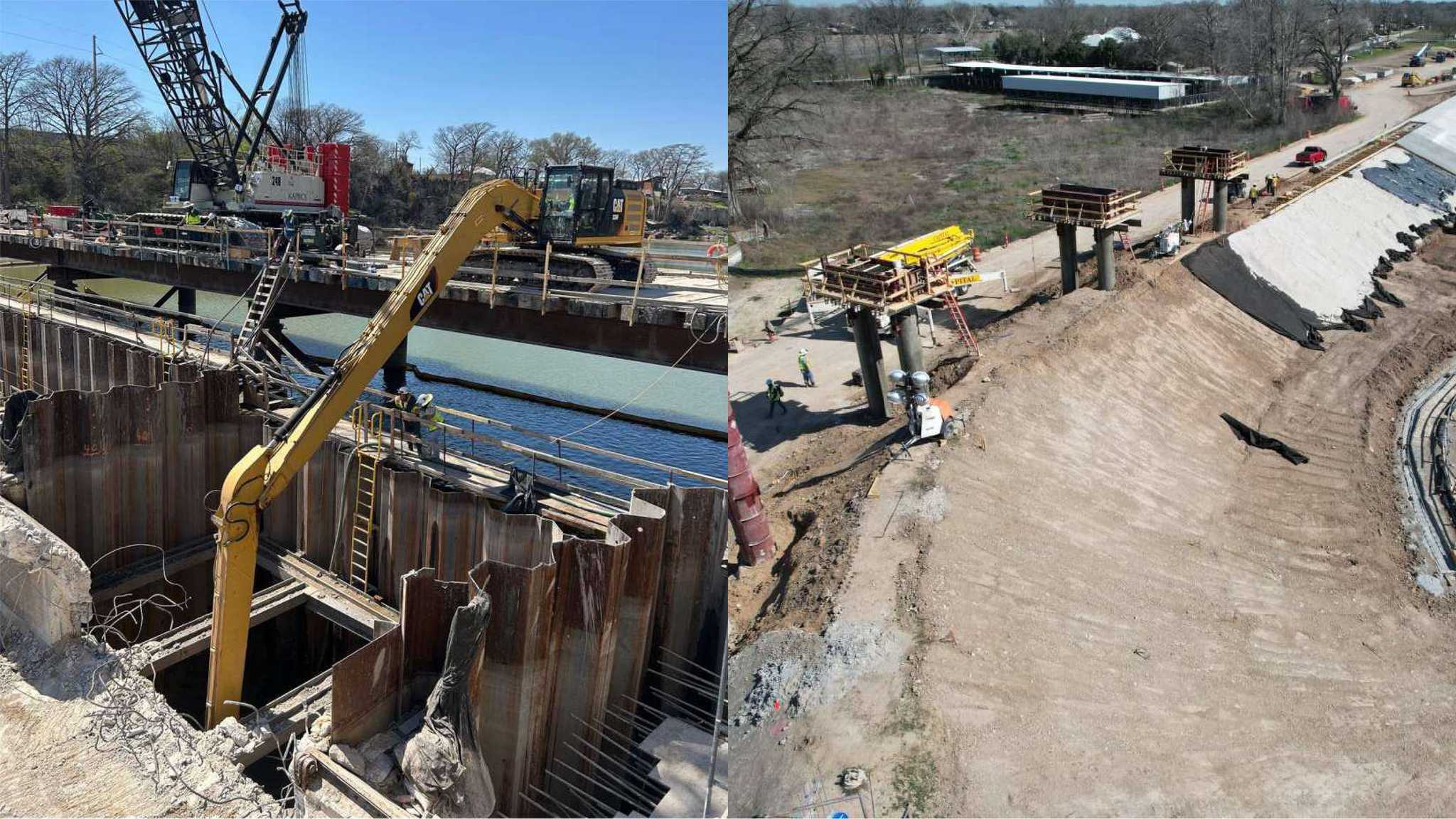

- Bay 2 cofferdam excavation - ongoing

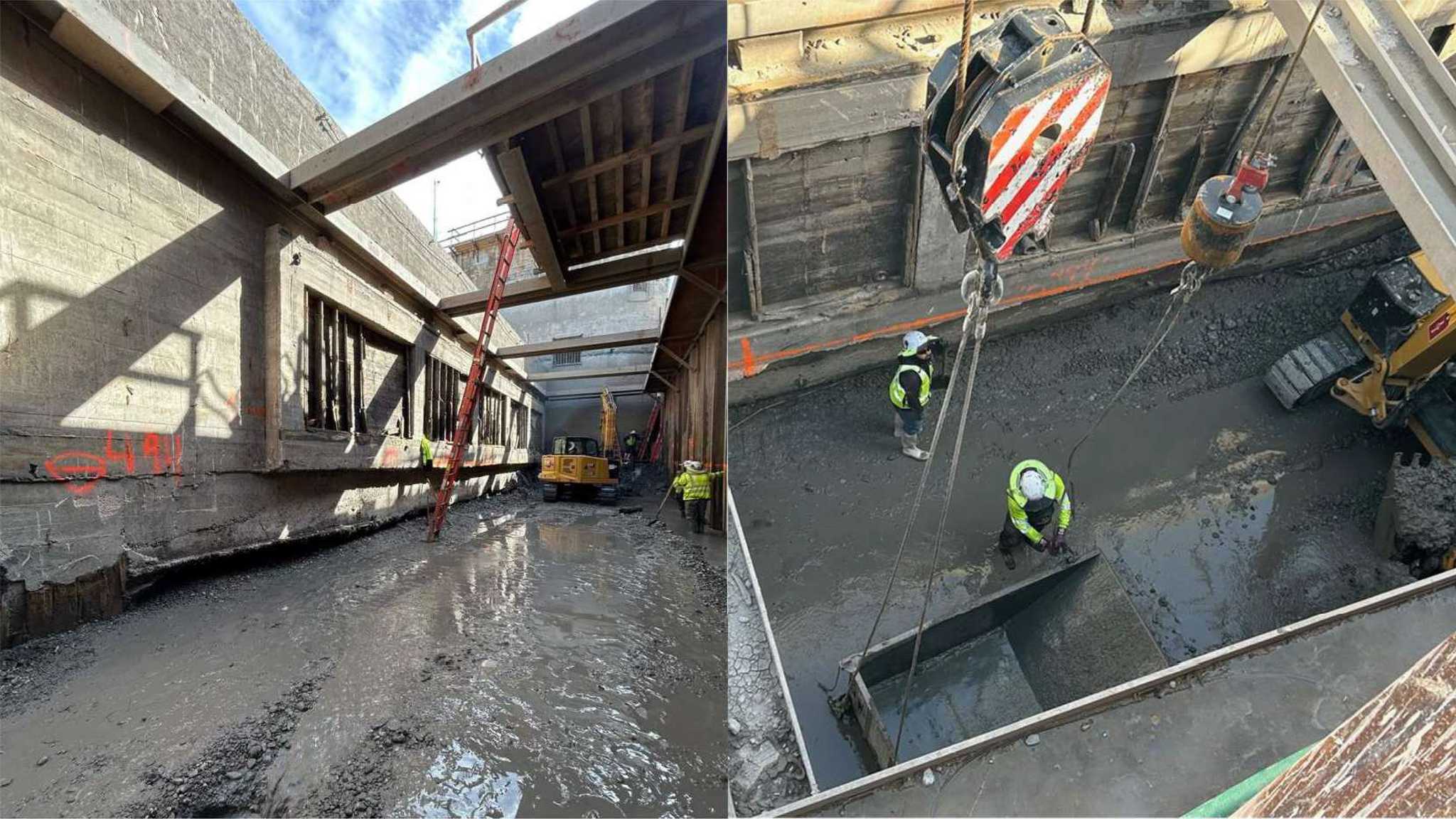

- Bay 2 structure demolition – ongoing (Doghouse being removed)
- Bay 3 cofferdam excavation - completed

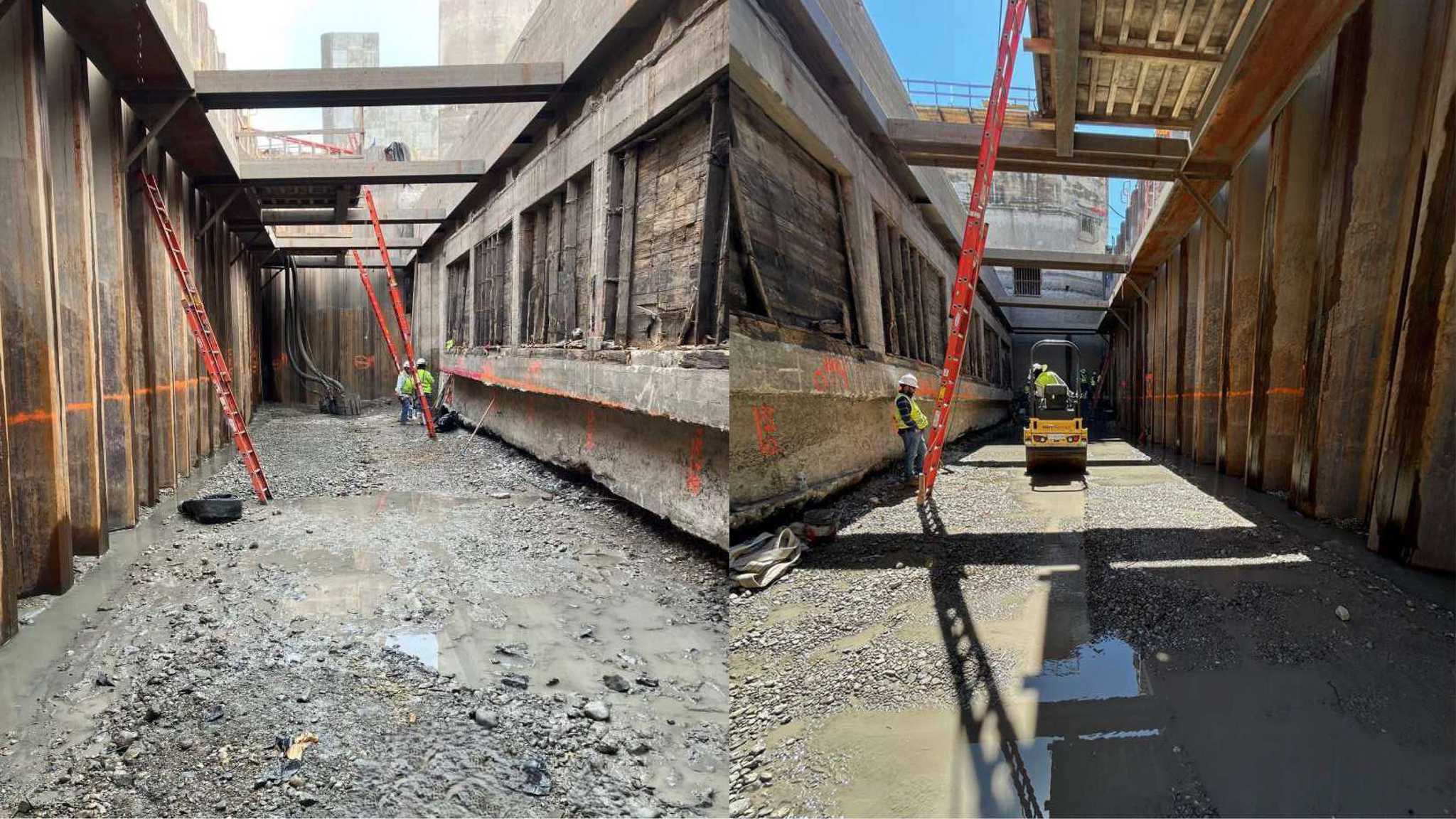

- Pier 3 structure demolition – ongoing (Doghouse remains)
- Maintenance bridge columns – completed
- Maintenance bridge bent caps – 3 out of 5 completed

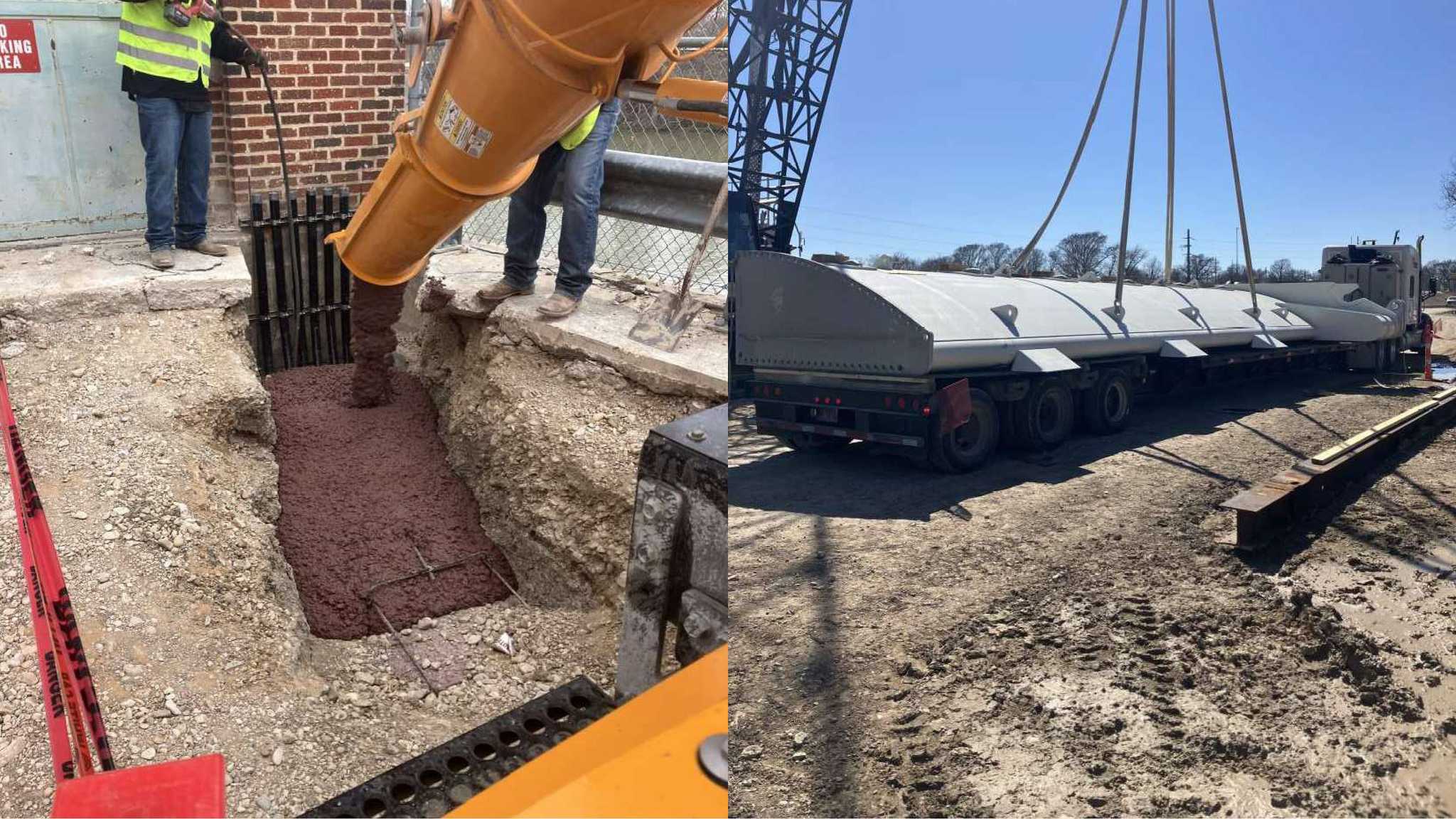

- South Embankment electrical – ongoing

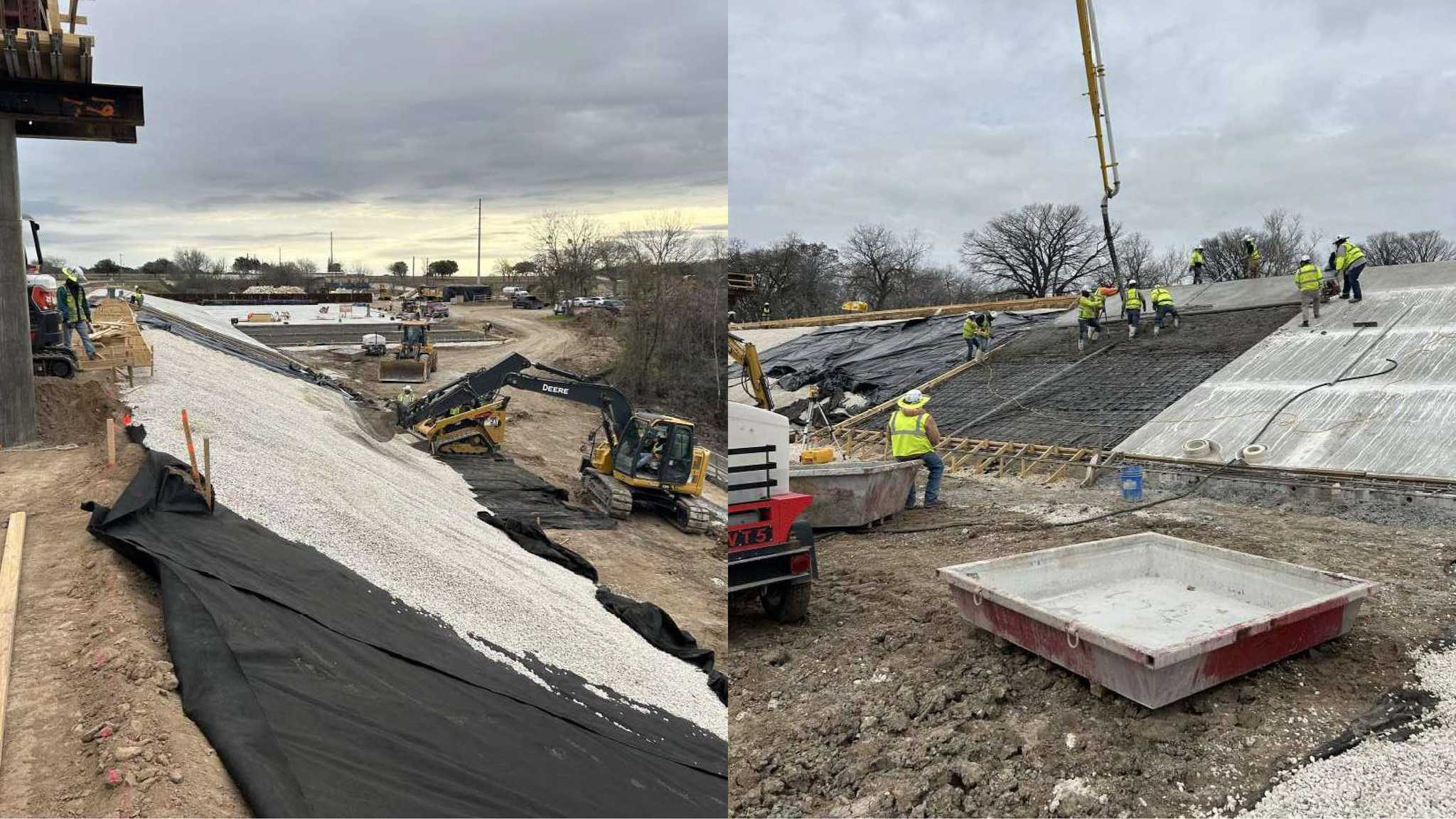

- North Embankment dam armoring - ongoing
Upcoming work:
- Bay 2 & 3 structure demolition – upstream doghouse
- Bay 2 cofferdam excavation
- Bay 3 concrete seal slab
- Bay 3 concrete foundation lift 1
- North downstream embankment armoring earthwork and concrete placements
- Powerhouse modifications
Steel-Fab, Inc (steel gate manufacturer)
- Gate manufacturing ongoing
- First gate components delivered. Delivery will continue through mid-June
If residents have additional questions regarding the Lake McQueeney Spill gate Replacement and Dam Armoring Project, please use the Contact Us form to submit your inquiries.
